C7 Scope: Terms and terminology

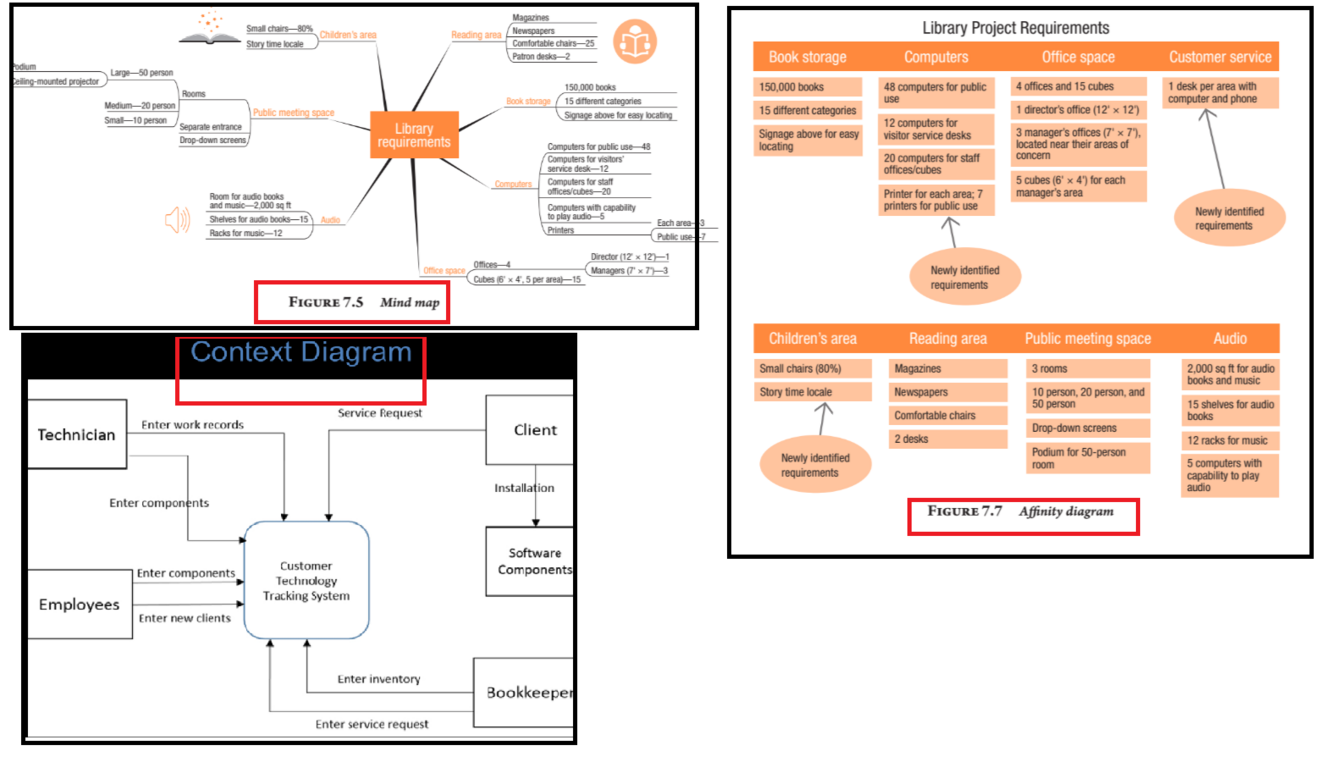

Method for Eliciting and Analyzing Requirements
Competing Requirements resolution
Best comply with:
Scope Statement
На входе - выровненные требования
На выходе:

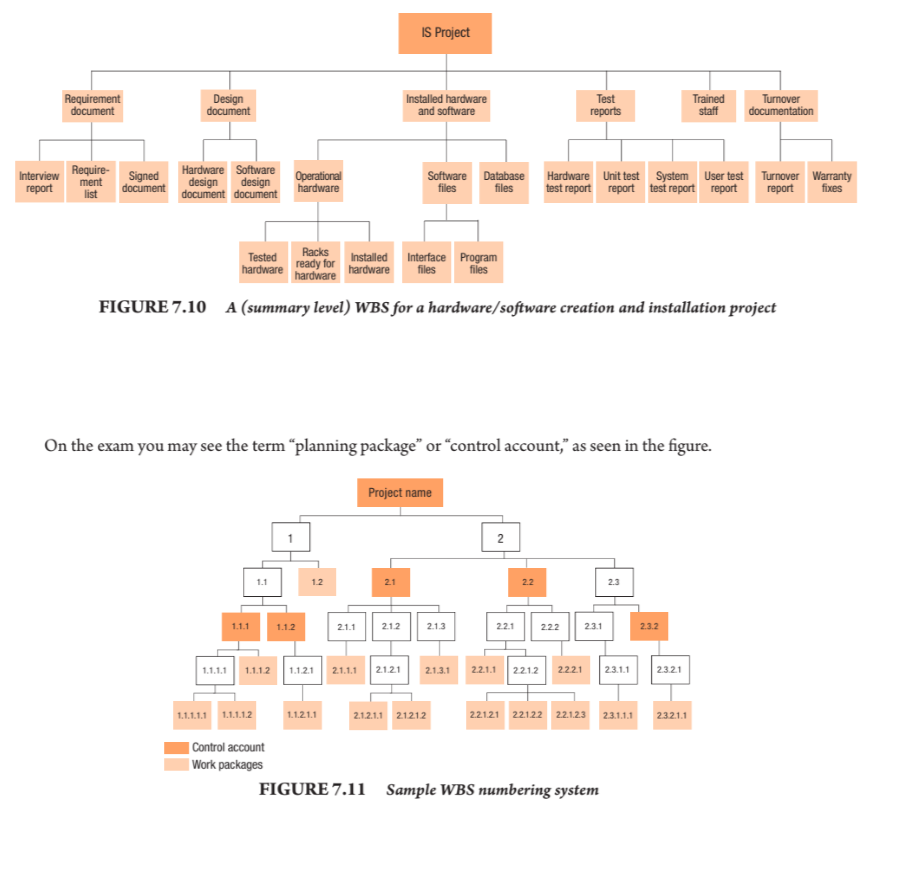

WBS / Control account / Planning package / Work package
WBS
Start from the name of the project, is decomposed to work packages
Control account
Allows to collectively manage and control cost/sched/scope at a higher level than the work package
Planning package
Located below a control account and above the work packages
Work package
Activity list - decomposition of WBS but do not included in WBS! Typically 80 hours max (?)
Methods for Agile Story Decomposition
Good story - INVEST:
Decomposition
(стр. 181)

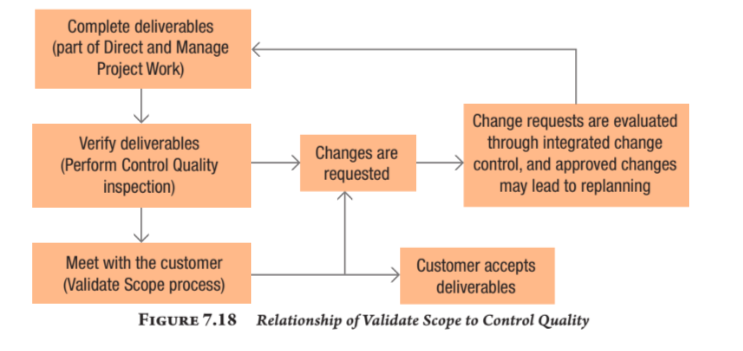

Validate and Control scope
Validate Scope
См. схему
Control Scope - контроллируем work performance data against Scope Baseline
